What is a lift plan

A lift plan is a document that outlines procedures and best practices that ensure safe lifting operations. On construction sites, any task that involves lifting equipment is planned, regulated, and carried out as per the information and guidelines given in a lift plan.

Whatโ€™s in a lift plan?

  1. Risk assessment
  2. Schedule of common lifts
  3. Method statement
  4. Weather regulations
  5. Lifting equipment
  6. Engineering drawings
  7. Site personnel
  8. Emergency procedures
  9. Legal and regulatory requirements
  10. Amendment sheets

Letโ€™s delve into these points a little.

Risk Assessment

Minimising risks is important in any workplace. A risk assessment identifies hazards and evaluates potential risks, then puts measures in place to reduce or eradicate those risks.

Lifting operations is within a safety-critical industry. Every lift has potential risks, so a risk assessment must be including in a lift plan prior to a lifting project commencing.

Schedule of Common Lifts

A Schedule of Common Lifts gives guidance on how to lift loads that are regularly lifted on construction sites. Separate guidelines get given for specialist lifts or rare lifts.

Sub-contractors who do the bulk of the work on a building before the fit-out carry out the work in accordance with a Schedule of Common Lifts. They lift certain loads regularly each day for the duration of their project.

Method Statement

Method statements are documents that map out how tasks are to be done on a project. They run in line with Risk Assessments in ensuring safe methods of work, but they expand on the Risk Assessments.

Weather Regulations

Wind

Also, certain loads mustnโ€™t be lifted when the wind reaches certain speeds that are below the maximum speeds that cranes can work at.

A lift plan states these wind speed limits for each specific piece of lifting machinery and load. The machineryโ€™s working wind limit may vary, depending on manufacturer guidelines.

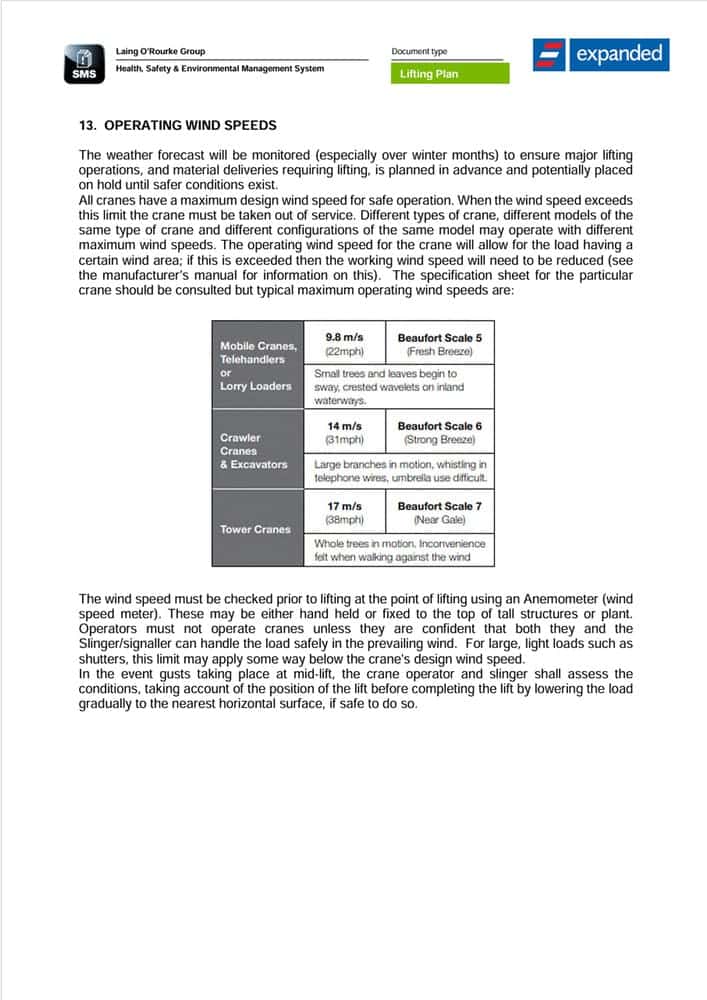

A section of a lift plan for lifting operations, that shows wind speed limits for certain cranes.

Precipitation

Temperature

As with precipitation, there are lifting accessories that mustnโ€™t be used at certain temperatures. Using a vacuum lifter as the example again, they should only be used between 0-40ยฐC (32-104ยฐF)

Lifting Equipment

Lift plans specify what lifting equipment is to be used, as well as the equipmentโ€™s configuration, capacity, and how regularly it should be LOLER inspected. This covers lifting machinery and accessories.

Engineering Drawings

Engineering drawings in a lift plan could include:

Lifting zones โ€“ Maps of the site, with each craneโ€™s location and the areas that they cover.

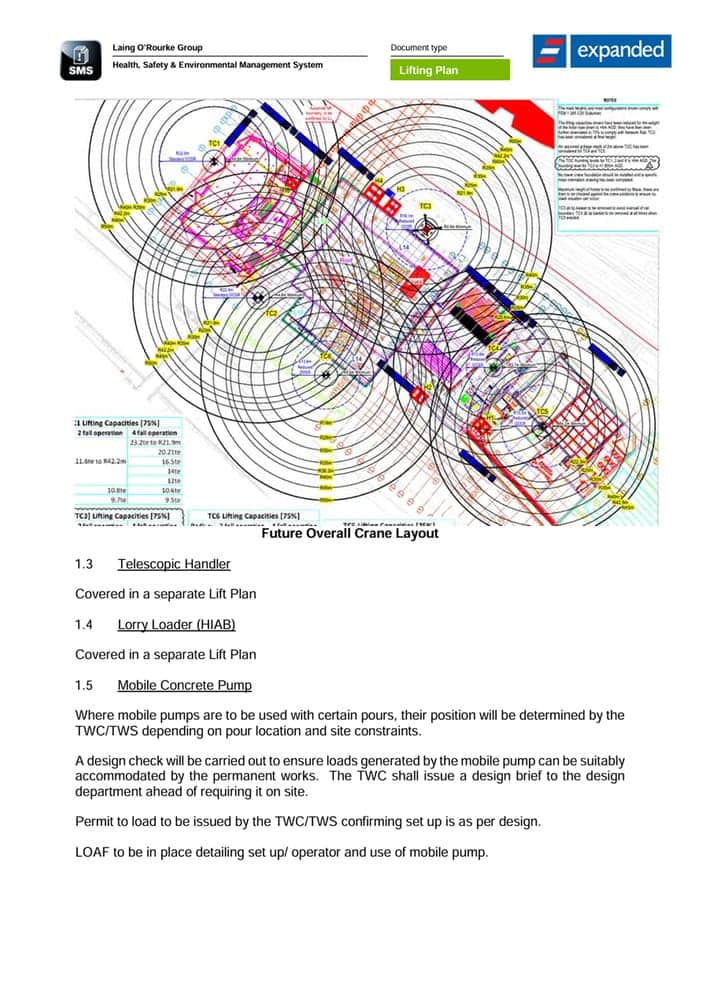

Part of a lift plan that shows a map of cranes.

Methods of slinging โ€“ The methods of how to attach each load to a crane when lifting the load.

Load lifting points โ€“ The points on each load that lifting accessories get attached to when lifting the load.

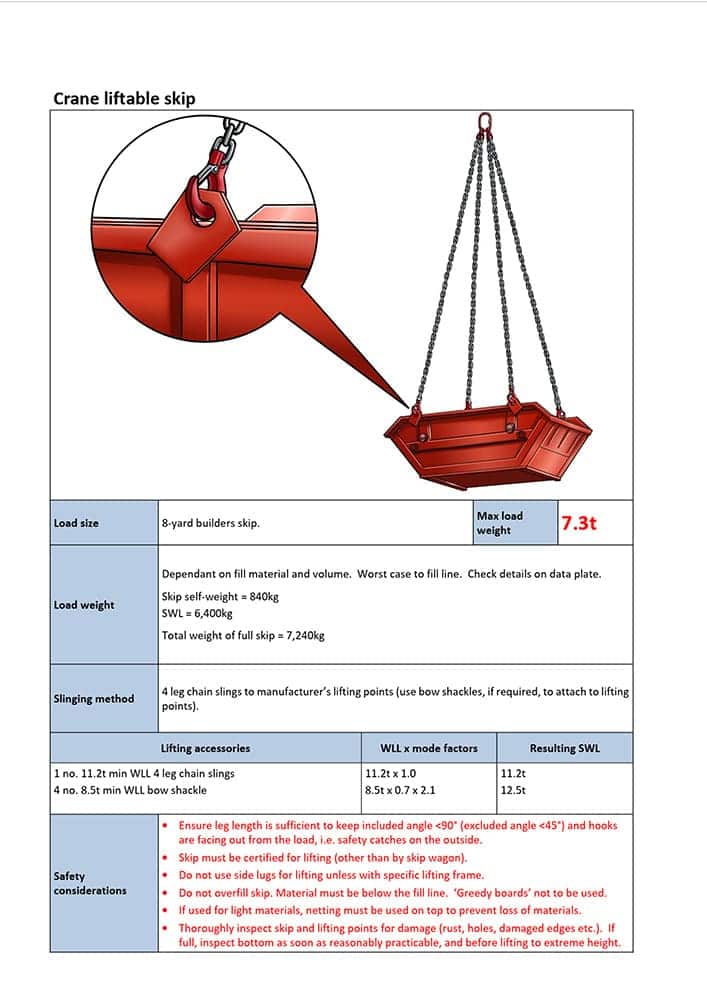

A section of a lift plan that shows how to use lifting points on a skip.

Site Personnel

This details all the people involved with lifting, site management, points of contact, crane rescue personnel, first aiders, etc.

A lift plan will hold copies of each lifting team memberโ€™s qualifications. It will also contain their signatures to show they have read and understood the lift plan. When revisions get made or additional elements included, they will also need to sign those.

Emergency Procedures

Primary accessories are used for the lift, but in case they fail, secondary chains are connected.

Legal and Regularity Compliance

A lift plan must comply with regulations or standards put in place.

Amendment Sheets

Certain parts of lift plans might get changed if needed. Also, other things might get added. These amendments get reviewed and approved by designated people prior to being put in place. Members of the lifting team should also study amendments made and sign up to them.

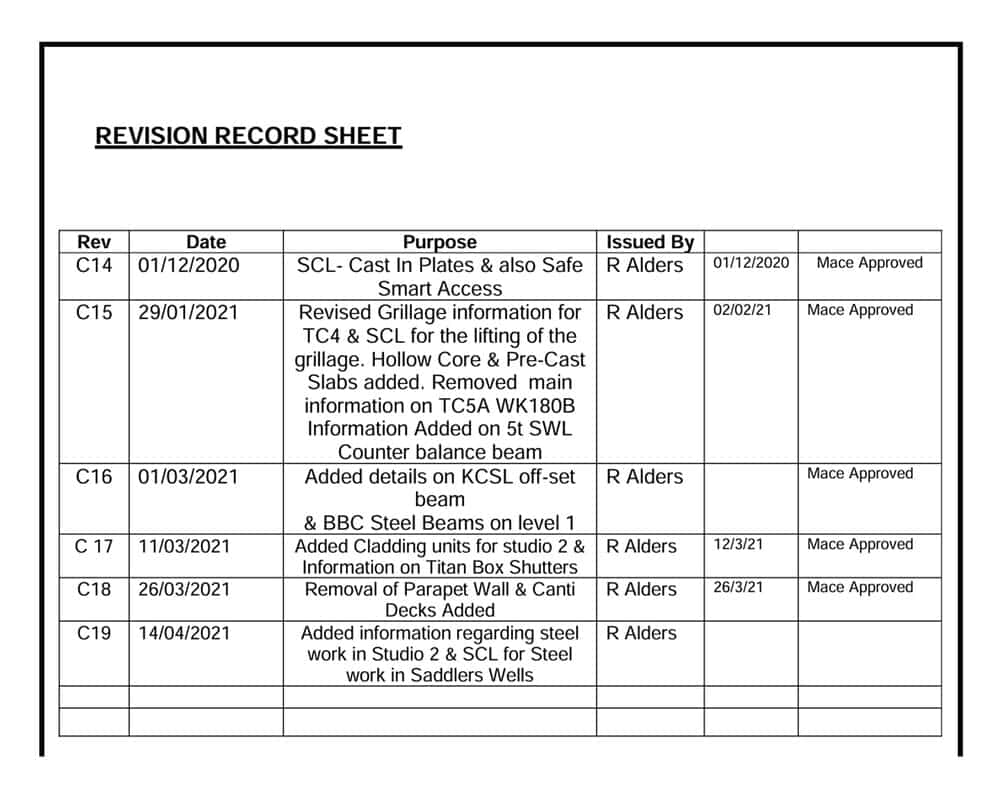

The revision/amendment sheet section of a lift plan for lifting operations.

Who creates a lift plan?

When planning, the chief AP might liaise with organisations that could be affected by cranes being used in or near their vicinity. Like local councils, Network Rail, and local airports or airfields.

Itโ€™s the APโ€™s job to choose cranes that are reliable, big enough to lift whatโ€™s needed, cost effective, and energy efficient.

For example, a crane thatโ€™s capable of lifting 60 tonne isnโ€™t the best option for a project where all the loads are under 10 tonne. This isnโ€™t economical, because the hire cost for the crane will be excessive. Plus, the energy it uses will be unnecessarily expensive, as well as potentially affecting the carbon footprint.
